How To Set Up A Server Room: Step-By-Step & Checklist

June 15, 2026

How To Set Up A Server Room: Step-By-Step & Checklist

Table of Contents

A poorly planned server room doesn’t just cause headaches, it causes downtime, equipment failures, and security risks that cost real money. Whether you’re building out a dedicated space for a hospital’s clinical systems, a commercial property’s network backbone, or a small business looking to centralize its IT, knowing how to set up a server room the right way from the start saves you from expensive rework later. The details matter: power, cooling, cabling, physical security, skip any of these and you’ll feel it within months.

At Trindom Global, we’ve designed and built server rooms and IT infrastructure environments across healthcare, commercial, hospitality, and government sectors. Our teams handle everything from structured cabling and headend buildouts to full equipment integration, so we’ve seen firsthand what separates a server room that runs reliably from one that becomes a constant problem. This guide reflects that experience.

Below, you’ll find a step-by-step walkthrough covering space planning, power and cooling requirements, cable management, security, and a printable checklist you can use to keep your project on track. We wrote it for IT managers, facilities teams, and business owners who want to get this right the first time, whether you’re starting from an empty room or upgrading what you already have.

Server room basics and planning checklist

Before you dive into construction or purchasing equipment, you need a clear picture of what you’re building and why. Every successful server room starts with honest answers about your current and future needs, budget, timeline, and the physical constraints of your building. Skipping this planning stage is the most common reason projects run over budget or require expensive retrofits within a year of going live.

Getting the planning stage right is the single most valuable step when figuring out how to set up a server room.

Define your requirements before you buy anything

Your first job is to document exactly what the space needs to support now and where it’s headed. Equipment count and weight load will determine your rack layout, floor reinforcement needs, and total power draw. Growth projections matter just as much: a room sized for today’s 10 servers may be completely inadequate in 18 months if your organization is scaling.

Work through these questions before any purchases or construction begins:

  • How many servers, switches, and storage units will you install at launch?
  • What is your projected equipment growth over the next 3 to 5 years?
  • What is your maximum power budget in kilowatts?
  • Do you need 24/7 uptime, or can you tolerate planned maintenance windows?
  • Who needs physical access to the room, and how often?

Use a checklist to track every critical element

A structured checklist keeps your project from developing blind spots. Each category below represents a system that must be planned in coordination with the others, not in isolation. Power affects cooling, cooling affects space layout, and space layout affects cabling, so treat these as one interconnected system rather than separate tasks.

Category Key Items to Confirm
Space Room size, floor load rating, ceiling height
Power Circuit capacity, UPS sizing, grounding
Cooling BTU requirements, airflow path, humidity control
Cabling Cable types, pathways, labeling standards
Security Access control, surveillance, audit logs
Monitoring Temperature sensors, remote alerts, uptime tracking

Step 1. Pick the right room and lay out the space

The room you choose sets hard limits on everything else in the project. Location within the building, access to electrical panels, proximity to network entry points, and structural load capacity all directly affect your cost and your timeline. When thinking through how to set up a server room, treat room selection as a technical decision, not just a space availability decision.

Choose a room with the right physical characteristics

Not every available room works. You need sufficient ceiling height (at minimum 9 feet to allow for overhead cable trays and proper airflow), a floor load rating that can handle dense rack equipment (typically 150 to 200 pounds per square foot), and no exterior walls facing direct sunlight if possible.

A room that checks all the boxes for size but fails on structural load will cost far more to retrofit than finding the right space from the start.

Avoid rooms near water pipes, HVAC drains, or restrooms. Water damage is the obvious risk, but humidity from nearby moisture sources can cause corrosion on equipment over time.

Plan your rack layout before you move anything in

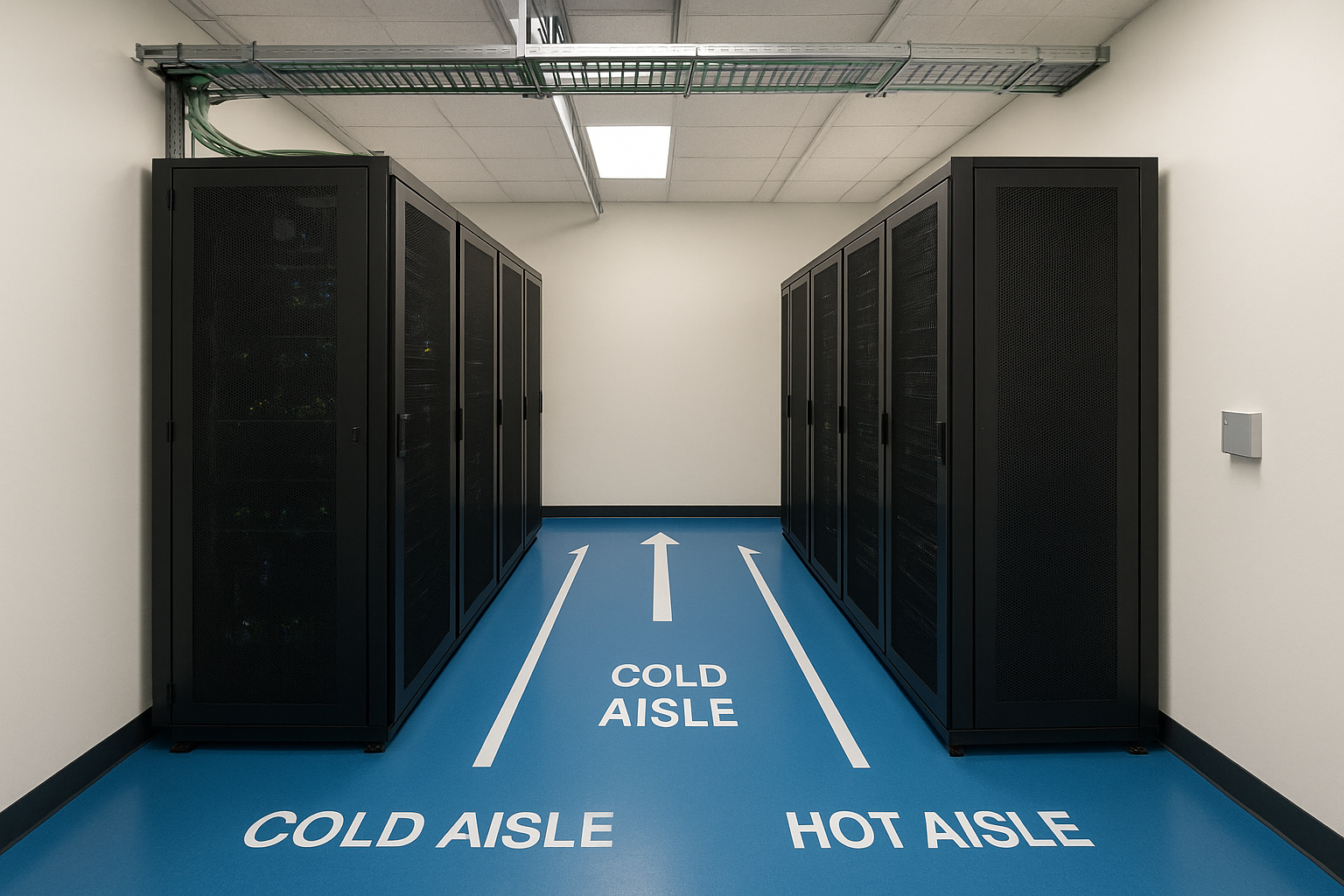

Sketch your floor plan before purchasing a single rack. Use a cold aisle and hot aisle arrangement so cooled air flows into the front of your racks and hot exhaust exits cleanly out the rear. Leave at least 36 inches of clearance at both the front and rear of every rack for safe maintenance access.

Plan your rack layout before you move anything in

  • Front aisle (cold): 36 to 48 inches minimum
  • Rear aisle (hot): 36 inches minimum
  • Side walls: 12 to 24 inches for cable routing

Step 2. Design power, grounding, and backup

Power failures and electrical problems account for a significant share of unplanned server downtime. Every circuit, outlet, and backup system in your server room needs to be sized and installed intentionally, because undersized power infrastructure is one of the most common and costly mistakes you can make when figuring out how to set up a server room.

Size your circuits and UPS correctly

Your total power draw determines everything from circuit breaker sizing to the UPS capacity you need. Add up the wattage of every piece of equipment you plan to install, then multiply by 1.25 to build in a safety margin. A UPS rated for your full load gives you enough runtime to either shut systems down cleanly or switch to a generator without data loss.

Size your circuits and UPS correctly

Plan your UPS capacity for your projected 3-year equipment load, not just what you’re installing today.

  • Calculate total load: add nameplate watts for all servers, switches, and storage
  • Add 25% overhead to your calculated total
  • Select a UPS with at least 10 to 15 minutes of runtime at full load
  • Install dedicated 20-amp or 30-amp circuits per rack, not shared building circuits

Ground every rack to protect your equipment

Improper grounding causes equipment damage that often looks like random hardware failures until a licensed electrician traces it back. Connect every rack to a dedicated ground bus bar that ties directly to your building’s main electrical ground, and use bonding jumpers between adjacent racks to eliminate ground loops before they damage anything.

Step 3. Control heat, airflow, and humidity

Thermal management is one of the most technically demanding parts of understanding how to set up a server room. Heat buildup kills equipment faster than almost any other single factor, and most server rooms end up under-cooled because cooling was sized for current equipment rather than projected load. Your cooling system needs to remove heat as fast as your equipment generates it, or temperatures climb and uptime drops within weeks of going live.

Calculate your cooling load before you purchase any equipment

Your total BTU (British Thermal Unit) requirement drives every cooling decision you make. The math is straightforward: 1 watt of power consumed produces approximately 3.41 BTUs of heat per hour. Multiply your total equipment wattage by 3.41 to get your baseline cooling requirement, then add 20% overhead for lighting, personnel, and future gear.

Size your cooling system for your 3-year projected load, not what you’re installing today.

  • 10kW of equipment generates roughly 34,100 BTUs per hour
  • Install a dedicated precision air conditioning unit rated above your calculated BTU total
  • Keep cold aisle temperatures between 65°F and 75°F (18°C to 24°C)

Keep humidity within safe operating limits

Too much moisture causes corrosion on circuit boards and connectors, while air that is too dry creates static discharge risks that can damage sensitive components without any visible warning. Target a relative humidity range of 45% to 55%, and install a dedicated humidity sensor with remote alerting so you catch any drift before it reaches hardware.

Step 4. Install racks, cabling, and labeling

How you physically install racks and run cabling directly affects long-term reliability and maintainability, which is a step many organizations rush through when figuring out how to set up a server room. Disorganized cabling leads to airflow blockages, accidental disconnections during routine maintenance, and troubleshooting delays that cost hours you don’t have.

Mount and secure your racks properly

Bolt every rack to the floor using the manufacturer’s provided floor mounting hardware. Free-standing, unanchored racks create a tipping hazard and violate most data center safety standards. If your floor is raised, secure racks to the subfloor structure, not just the access tiles, to distribute weight correctly.

A rack that isn’t floor-anchored puts both your equipment and your technicians at risk during any maintenance activity.

  • Use 42U or 45U racks for maximum density in a standard-height room
  • Install blanking panels in every empty rack unit to block hot air recirculation
  • Leave the top 2U open for cable management arms
  • Run cables through dedicated vertical and horizontal cable managers inside each rack

Label everything before it goes live

Consistent labeling on every cable, port, and rack position saves hours during troubleshooting. Set your naming convention before you pull a single cable through conduit, and stick to it across every piece of gear in the room.

Label Type Format Example
Server SVR-01-RACK-A
Network cable NET-SW01-P03
Power cable PWR-UPS1-C04
Patch panel port PP-A-12

Step 5. Lock down access and add monitoring

Physical security and real-time monitoring are the final layer in how to set up a server room that stays reliable long after installation day. Unauthorized access and undetected environmental changes are two of the most preventable causes of server room incidents, yet both get treated as afterthoughts on many projects.

Control physical access with layered authentication

Your server room door should require at minimum a keycard or PIN-based access system tied to a log that records every entry and exit with a timestamp. Biometric readers add a second factor for environments handling sensitive data or regulated equipment.

Keep your access log active and review it monthly to catch any unusual entry patterns before they become a real problem.

  • Install a keycard or PIN reader on the primary door
  • Add a secondary authentication factor for high-security environments
  • Store access logs off-site or in a cloud-based system for tamper resistance
  • Mount a camera covering the entry point and retain footage for at least 30 days

Install sensors and set up remote alerts

Temperature, humidity, and power sensors give you early warning before conditions reach the point of equipment damage. Connect every sensor to a monitoring platform that pushes real-time alerts to your phone or email so you can respond immediately, even when no one is physically on-site. Check that each alert threshold is tested and confirmed before you consider the room operational.

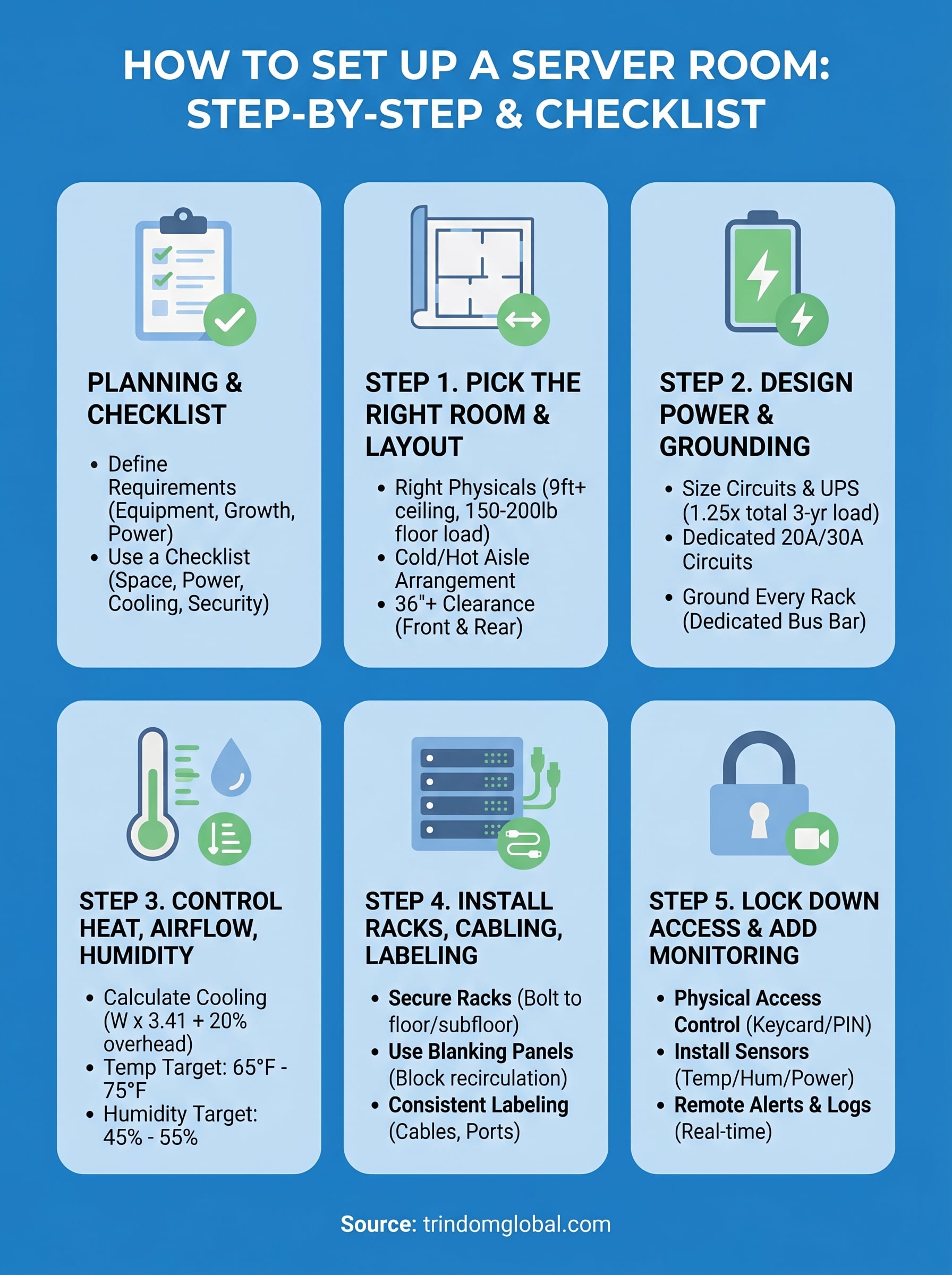

how to set up a server room infographic

Next steps

You now have a complete framework for how to set up a server room that holds up under real operational pressure. Space selection, power design, cooling, cabling, and physical security each depend on the decisions you make in the steps before them, so work through the process in order and resist the urge to skip ahead to purchasing equipment before the planning is solid.

If your project involves a healthcare facility, commercial building, or government environment, the technical complexity increases significantly. Structured cabling, headend buildouts, and equipment integration in these settings require licensed professionals who understand both the infrastructure requirements and the regulatory constraints of each sector.

Trindom Global works with organizations across healthcare, commercial, hospitality, and government sectors to plan, design, and build IT infrastructure environments. Reach out to our team if you want experienced professionals handling the installation and integration work, so your server room comes online correctly the first time.
