A single cooling failure can take down an entire server room in minutes. Servers generate significant heat, and without properly calculated server room cooling requirements, that thermal energy accumulates fast, pushing hardware past safe operating thresholds, triggering shutdowns, and in worst cases, causing permanent damage to critical equipment. Whether you’re building out a new server room or upgrading an existing one, getting the environmental controls right isn’t optional.
The core question is straightforward: how much cooling does your space actually need? The answer depends on your total heat load, room size, rack density, and the temperature and humidity ranges your equipment demands. Industry guidelines from ASHRAE provide a solid starting point, but translating those specs into a working cooling design takes careful calculation and planning.
At Trindom Global, we design and build IT infrastructure environments from the ground up, including the structured cabling, headend buildouts, and equipment integration that go into server rooms across healthcare, commercial, and government facilities. Cooling is one of the first things we address in any build because everything else depends on it. This guide walks you through the temperature and humidity standards, heat load calculations, and cooling capacity sizing you need to get your server room environment right.
What server room cooling requirements include
Server room cooling requirements cover more than just buying an air conditioner. They define temperature and humidity bands your equipment must stay within, the airflow patterns that move heat away from hardware, and the total cooling capacity needed to offset what your servers actually generate. Getting any one of these wrong undermines the others, so you need to treat them as a connected system rather than separate checkboxes.
Temperature and humidity standards
The most widely cited framework for server room cooling comes from ASHRAE Technical Committee 9.9, which publishes thermal guidelines for data processing environments. For most server rooms, the recommended intake air temperature falls between 18°C and 27°C (64°F to 80.6°F), with an allowable expanded range up to 35°C for short durations. Relative humidity should stay between 40% and 60% to prevent both static buildup from dry air and condensation from excess moisture.
Staying within ASHRAE’s recommended range rather than the expanded allowable range extends hardware lifespan and reduces the risk of unplanned shutdowns.
| Parameter | Recommended Range | Allowable Range |
|---|---|---|
| Inlet Air Temperature | 18°C – 27°C (64°F – 80.6°F) | 5°C – 35°C (41°F – 95°F) |
| Relative Humidity | 40% – 60% | 8% – 80% |
| Dew Point | 5.5°C – 15°C | -12°C – 17°C |
Airflow and containment
Your cooling system needs to move cold air to the right places and pull hot air out before it recirculates back into server intakes. Hot aisle/cold aisle containment is the standard approach: cold air is delivered under raised floors or through overhead ducts to the front of racks, servers exhaust heat out the back into a hot aisle, and that hot air gets routed back to the cooling units. Without containment, hot spots develop between racks where inlet temperatures can spike well above room averages, stressing equipment even when your room-level sensors show normal readings.

Heat load and cooling capacity
Every piece of powered equipment in your server room contributes to the heat load your cooling system must handle. Power usage and heat output are directly linked: roughly every watt of power consumed produces one watt of heat. Your cooling capacity, measured in BTUs per hour or tons of refrigeration, needs to exceed your total calculated heat load with enough headroom for future equipment additions and partial cooling-unit failures. A room running at 100% cooling capacity leaves no buffer when you add a new rack or lose a unit unexpectedly.

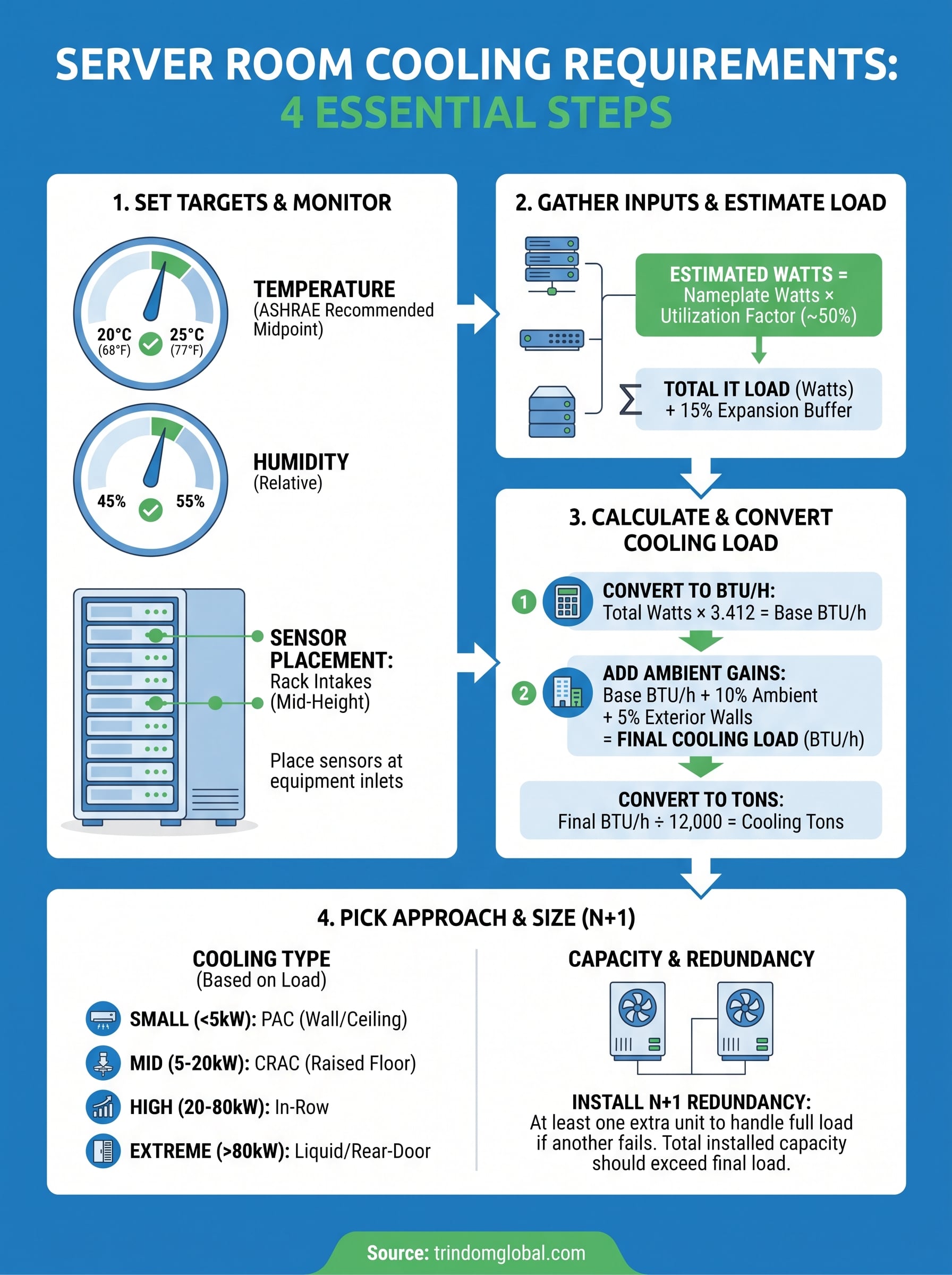

Step 1. Set temperature, humidity, and monitoring targets
Before you calculate anything, you need to lock in your target environmental ranges and decide how you’ll measure and verify them continuously. These numbers become the baseline for every cooling decision that follows. Without defined targets, you can’t confirm your system is working or catch drift before it causes hardware problems.
Define your target ranges
Your server room cooling requirements start with specific numbers, not vague goals. Use ASHRAE’s recommended ranges as your operating targets, not the outer allowable limits. Set your intake air temperature target at 20°C to 25°C (68°F to 77°F) as a practical midpoint within the recommended band. Set relative humidity to 45% to 55%. These tighter targets give your system buffer room before you hit the edges of the acceptable range.
Targeting the middle of ASHRAE’s recommended band rather than the edges gives your cooling system room to absorb fluctuations without pushing equipment into risky territory.
Set up continuous monitoring
You can’t manage what you can’t measure. Place temperature and humidity sensors at server intake points, not just at room level, because hot spots at rack intakes can read 10°C to 15°C above the room average. Aim for at least one sensor per rack row at mid-height intake level.
Use a baseline monitoring checklist to verify your setup covers:
- Rack-level intake sensors (front of rack, mid-height)
- Room ambient temperature and humidity at two or more points
- Cooling unit supply and return air temperatures
- Alert thresholds set at 26°C intake temperature and 60% relative humidity
- Logging intervals of 5 minutes or less for accurate trend analysis
This data becomes the foundation for troubleshooting and capacity planning as your environment grows.
Step 2. Gather inputs and estimate real heat output
Before you can size any cooling system, you need accurate numbers for every piece of equipment in your server room. Nameplate power ratings are a starting point, but they overstate real-world consumption because they list maximum draw, not typical operating load. Gathering the right inputs here directly determines whether your server room cooling requirements end up sized correctly or leave you with a system that’s either inadequate or wasteful.
Collect your equipment data
Pull the nameplate wattage from every device in the room: servers, switches, storage arrays, UPS units, and patch panel power supplies. Then apply a utilization factor to estimate actual draw rather than theoretical maximum. Most servers run at 40% to 60% of rated capacity during normal operations.
Use this input template to document each piece of equipment:
| Equipment | Nameplate Watts | Utilization Factor | Estimated Watts |
|---|---|---|---|
| Server (1U) | 500W | 50% | 250W |
| Network switch | 150W | 70% | 105W |
| Storage array | 800W | 60% | 480W |
| UPS unit | 1000W | 85% | 850W |
Using nameplate ratings without a utilization factor leads to significant oversizing, which drives up capital costs and often results in cooling systems that short-cycle and perform poorly.
Estimate actual heat output
Once you have estimated watt values for each device, sum them to get your total IT load. Remember that every watt consumed converts to one watt of heat, so your total estimated wattage equals your total heat load in watts. Add 10% to 15% on top of your summed load to account for planned expansion and any equipment you may have missed during inventory. This adjusted number is the figure you carry into the cooling load calculation in the next step.
Step 3. Calculate cooling load and convert units
Your adjusted watt total from Step 2 is now your working number. This step converts that figure into the units your cooling equipment is rated in and adds the corrections that account for heat sources beyond your IT gear. Skipping these adjustments is one of the most common reasons server room cooling requirements get undersized during the design phase.
Convert watts to BTU/h
Cooling equipment is rated in BTU per hour (BTU/h), not watts, so you need to convert before you can compare your load against any unit’s specs. The conversion factor is fixed: 1 watt equals 3.412 BTU/h. Multiply your adjusted IT load by 3.412 to get your base cooling load.

Use this calculation template as a reference:
| Input | Value |
|---|---|
| Estimated IT load | 4,500W |
| +15% expansion buffer | 675W |
| Adjusted total | 5,175W |
| Conversion factor | x 3.412 |
| Base cooling load | 17,657 BTU/h |
Running this conversion before spec-checking any cooling unit prevents you from comparing watt figures against BTU-rated equipment and selecting a system that falls short under real load.
Add ambient heat gains
Your IT equipment is not the only heat source in the room. Lighting, exterior walls, and anyone working in the space all push additional heat into the environment. Add 10% to your base cooling load to cover standard ambient heat gain. If your server room has exterior walls exposed to direct sunlight or unconditioned spaces, add another 5% on top.
Apply those additions like this:
- Base cooling load: 17,657 BTU/h
- Ambient heat gain (10%): +1,766 BTU/h
- Exterior wall exposure (5%): +883 BTU/h
- Final cooling load: 20,306 BTU/h
Cooling units are frequently sized in tons of refrigeration, where 1 ton equals 12,000 BTU/h. Divide your final BTU/h total by 12,000 to get the minimum tonnage required. For this example, 20,306 divided by 12,000 gives you 1.69 tons, which means you select a 2-ton unit as your baseline minimum.
Step 4. Pick the right cooling approach and size
Your final cooling load figure tells you how much capacity you need. Now you need to match that requirement to a cooling technology that fits your room’s layout, power infrastructure, and growth plans. Not every cooling approach works for every environment, so the decision depends on your rack density, floor space, and available infrastructure.
Choose a cooling type that fits your room
Different room configurations call for different systems. A small server room with a few low-density racks has different server room cooling requirements than a high-density environment running multiple rows of fully loaded servers. Use the table below to match your situation to the right cooling approach before committing to any equipment purchase.
| Room Type | Typical IT Load | Recommended Approach |
|---|---|---|
| Small room, low density | Under 5 kW | Precision air conditioner (PAC), wall or ceiling mounted |
| Mid-size room, mixed density | 5 kW to 20 kW | Computer room air conditioner (CRAC) unit with raised floor |
| High-density rows | 20 kW to 80 kW | In-row cooling units placed between racks |
| Extreme density or large scale | 80 kW+ | Liquid cooling or rear-door heat exchangers |
Selecting in-row cooling for high-density environments reduces the distance between the heat source and the cooling unit, which improves efficiency and eliminates hot spots that overhead systems frequently miss.
Verify capacity and redundancy
Once you select a cooling type, size your installed capacity above your calculated load. A standard rule is to install at least N+1 redundancy, meaning one additional cooling unit beyond what your load requires. If one unit fails, your remaining units carry the full load without interruption. For a 2-ton requirement, install two 2-ton units running at partial load rather than one unit at maximum capacity.
Confirm your final sizing covers these three points before ordering equipment:
- Installed capacity exceeds your final BTU/h calculation by at least 20%
- At least one backup unit can handle full load independently
- Each unit’s airflow rating matches your hot aisle/cold aisle containment layout

Quick wrap-up
Proper server room cooling requirements come down to four connected steps: setting your target temperature and humidity ranges, auditing your actual equipment load, converting that load into BTU/h with the right adjustment factors, and selecting a cooling system with enough capacity and redundancy to handle both your current needs and future growth. Skipping any one of these steps leaves gaps that show up as hot spots, premature hardware failures, or systems that fail under peak load.
Your calculated cooling load is not a one-time number. As you add equipment or increase rack density, revisit your heat load estimate and confirm your installed cooling capacity still covers the adjusted total with N+1 redundancy intact. Treat your monitoring data as a regular input to that process, not just an alarm trigger.
If you’re building out or upgrading a server room and want expert guidance on the full environment, contact the Trindom Global team to discuss your project requirements.
