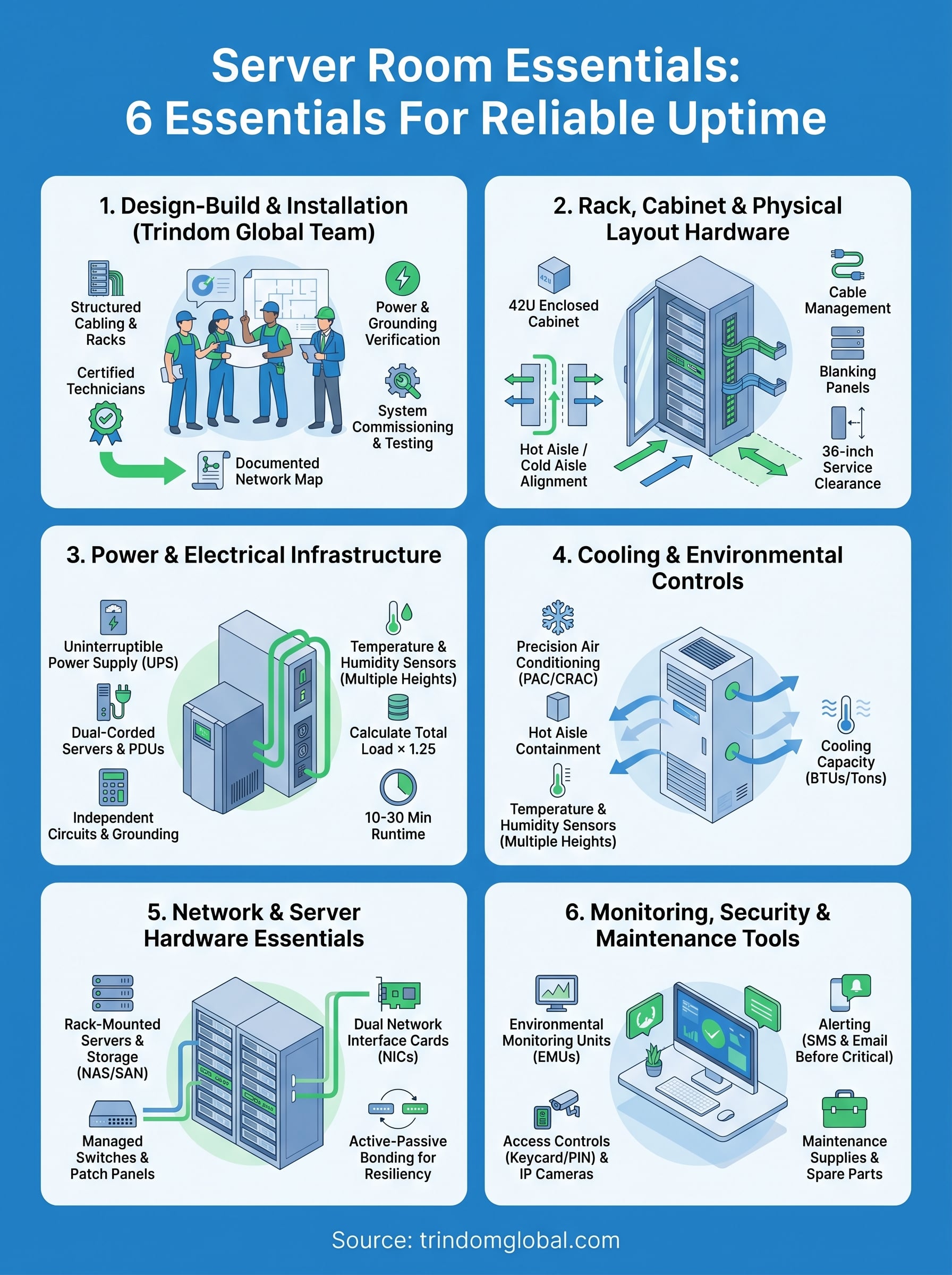

A missing UPS, an undersized cooling unit, or a poorly planned cable layout can turn a routine Tuesday into an emergency. The difference between a server room that runs quietly in the background and one that keeps you up at night often comes down to having the right server room equipment list before you start racking hardware. Yet many organizations rush past the planning phase, only to retrofit critical components later, at two or three times the cost.
At Trindom Global, we design, build, and install IT infrastructure for hospitals, commercial facilities, and government agencies. We’ve walked into enough half-finished server rooms to know exactly which pieces get overlooked, and which ones matter most. That hands-on experience across hundreds of deployments is what shaped this guide.
Below, you’ll find the six essential equipment categories you need to stand up a server room built for reliable uptime, from the core compute hardware to the environmental and power systems that protect it.
1. Trindom Global design-build and installation team
Before you touch a single piece of hardware, you need a team that can translate a server room equipment list into a certified, functioning installation. Trindom Global provides end-to-end design-build and installation services for IT infrastructure, meaning one team manages the full scope from initial site assessment through final commissioning.
What it includes
Trindom Global’s service covers the complete physical build-out of your server room environment. Certified technicians handle structured cabling, rack installation, power and grounding verification, cooling coordination, and network integration. A dedicated project manager oversees vendor scheduling and sequencing so equipment doesn’t arrive on-site before the electrical work is ready. Core deliverables include:
- Site survey and feasibility assessment
- Structured cabling and patch panel installation
- Rack mounting and cable management
- Power and grounding verification
- System commissioning and testing
How to scope it for your environment
Your scope depends on room square footage, the number of racks you plan to populate, and the density of equipment per rack. A 10-rack commercial office installation differs significantly from a 40-rack hospital server room with redundant power requirements. Trindom Global conducts a pre-project discovery session to define the right scope before any work begins, which prevents expensive change orders later.
Getting the scope right before the project starts is the single most effective way to protect your budget and your timeline.
Install and handoff details that protect uptime
Every installation follows a structured commissioning process that includes cable labeling, patch documentation, and a full system test before handoff. You receive as-built drawings and a documented network map so your internal team can manage the environment without guesswork. That documentation alone is what separates a room that runs cleanly on day one from one that generates trouble tickets for years.
Typical cost range
Project costs vary based on room size, equipment density, and compliance requirements. A standard commercial server room installation typically falls in the $15,000 to $80,000 range, while hospital and government projects often run higher due to certification requirements and stricter documentation standards.
2. Rack, cabinet, and physical layout hardware
Racks and cabinets form the physical backbone of your server room. Without the right enclosures and a deliberate layout plan, even the best hardware becomes harder to manage, cool, and troubleshoot. This category deserves early attention on any server room equipment list because layout decisions made at the start are expensive to reverse later.
What it includes
This category covers standard 19-inch equipment racks, open-frame relay racks, enclosed cabinets with lockable doors, cable management arms, horizontal and vertical cable managers, blanking panels, and mounting hardware. Raised floor tiles or overhead cable trays may also fall under this category depending on your facility design.
How to size and select
Your rack height, measured in rack units (U), should reflect current equipment plus at least 30 percent planned growth. A 42U cabinet is the most common choice for mixed server and network environments. Choose enclosed cabinets for environments with shared facility access, and open-frame racks for dedicated, controlled rooms where technician access is frequent.
Buying undersized racks to save cost upfront almost always forces a full rack replacement within two to three years.
Layout details that prevent failures
Hot aisle and cold aisle alignment is the single most effective layout choice you can make. Arrange racks so equipment exhausts into a shared hot aisle, keeping cool air intake on the opposite side. Leave adequate service clearance of at least 36 inches at the front and rear of every cabinet.

Typical cost range
Open-frame racks run $200 to $600 per unit, while enclosed cabinets with cable management typically range from $800 to $2,500, depending on depth, load capacity, and security features.
3. Power and electrical infrastructure
Power failures and electrical faults are among the top causes of unplanned server room downtime. Getting this category right on your server room equipment list protects every other piece of hardware you install.
What it includes
This category covers uninterruptible power supplies (UPS), power distribution units (PDUs), automatic transfer switches (ATS), dedicated circuit breakers, grounding systems, and surge protection devices. Your facility’s electrical panel may also require upgrades to support the load your equipment draws.
How to size and select
Calculate your total power draw in kilowatts before selecting any UPS or PDU. Add up the rated wattage of every device you plan to install, then multiply by 1.25 to build in a safety buffer. Choose a UPS with a runtime that matches your recovery window, typically 10 to 30 minutes for most environments, which gives your team enough time to execute a controlled shutdown.
Undersizing your UPS is one of the fastest ways to guarantee data loss during a grid event.
Redundancy and safety details that matter
Dual-corded servers connected to separate PDUs on independent circuits give you the redundancy you need to survive a single power path failure. Make sure all circuits are labeled, load-balanced, and tested before equipment goes live.
Typical cost range
A commercial-grade UPS for a small server room typically runs $1,500 to $8,000, while full PDU sets, ATS units, and panel upgrades for larger deployments can push total power infrastructure costs to $20,000 or more.
4. Cooling and environmental controls
Heat is the silent killer of server room hardware. Without adequate cooling and environmental monitoring, even properly sized power infrastructure cannot protect your equipment from premature failure. Every server room equipment list needs a dedicated cooling strategy before you power on a single device.
What it includes
This category covers precision air conditioning units (PAC or CRAC units), in-row cooling systems, ceiling-mounted or portable supplemental cooling, temperature and humidity sensors, and environmental monitoring controllers. Raised floor plenums and hot aisle containment systems also fall here.
How to size and select
Cooling capacity is measured in BTUs or tons, and your calculation starts with your total server wattage. One kilowatt of IT load produces roughly 3,412 BTUs per hour, so a 20kW server room needs at least a 5-ton cooling unit before adding any facility heat load. Always size up by 20 to 30 percent to handle peak loads and future growth.
Undersizing your cooling unit by even one ton can raise rack-level temperatures enough to trigger thermal shutdowns during heavy workloads.
Airflow management and hot spots to avoid
Blanking panels in every unused rack unit prevent hot exhaust air from recirculating into equipment intakes, which is one of the most common and easily fixed sources of hot spots. Position temperature sensors at multiple rack heights, not just at floor level, since heat stratifies and top-of-rack temperatures routinely run 10 to 15 degrees higher.

Typical cost range
A dedicated precision cooling unit for a small to mid-size server room typically runs $3,000 to $15,000, with hot aisle containment systems and environmental monitoring hardware adding $1,000 to $5,000 depending on room complexity.
5. Network and server hardware essentials
The compute and connectivity layer is where your server room equipment list becomes tangible. Without the right switches, servers, and storage hardware, the power and cooling infrastructure you’ve built has nothing to support.
What it includes
This category covers rack-mounted servers, network switches (access, distribution, and core tiers), patch panels, fiber and copper interconnects, network-attached storage (NAS) or storage area network (SAN) arrays, and top-of-rack cabling. Load balancers and firewalls also belong here, since they sit inline with everything else in the stack.
How to size and select
Start with your workload requirements, not your budget. Calculate the CPU cores, RAM, and storage IOPS your applications actually need, then add a 25 percent headroom buffer for growth. Choose managed switches over unmanaged ones at every tier; the ability to configure VLANs and monitor port traffic is not optional in a production environment.
Buying servers based on current workloads without headroom built in is the fastest path to an emergency hardware refresh 18 months later.
Resiliency basics for reliable uptime
Dual network interface cards (NICs) bonded in an active-passive configuration protect you from a single NIC or cable failure. Connect each bonded pair to separate switches on separate upstream paths to eliminate the switch itself as a single point of failure.
Typical cost range
Entry-level rack servers run $2,000 to $8,000 per unit, while managed switches for a small server room typically cost $500 to $5,000 depending on port count and throughput requirements.
6. Monitoring, security, and maintenance tools
A server room that runs without visibility is a server room that surprises you at the worst possible time. Monitoring tools, access controls, and routine maintenance supplies round out any complete server room equipment list and protect the investment you’ve made in every other category.
What it includes
This category covers environmental monitoring units (EMUs), temperature and humidity sensors, IP-enabled cameras, electronic door access controls, smoke and water detection sensors, and rack-level power monitoring. Maintenance tools such as anti-static wrist straps, cable testers, and a managed spare parts inventory also belong here.
How to choose sensors and alerting
Place temperature sensors at multiple rack heights and configure your monitoring platform to send alerts before thresholds become critical, not after. Choose a system that delivers notifications via SMS and email simultaneously so alerts reach someone regardless of what they happen to be doing at the time.
An alert that fires at 85°F gives you time to act; an alert that fires at 95°F gives you a post-mortem.
Physical security and safety essentials
Electronic keycard or PIN access restricts server room entry to authorized personnel and creates a time-stamped audit trail you can reference during incident reviews. Pair that with IP cameras recording at the entry point and inside the room so any unauthorized access that bypasses the door control is still captured on record.
Typical cost range
A basic environmental monitoring setup with alerting runs $500 to $3,000, while a full access control and camera system typically costs $2,000 to $8,000 depending on the number of entry points and cameras your facility requires.

Next Steps
Working through a complete server room equipment list before you break ground is the fastest way to protect your budget and your uptime. The six categories in this guide cover everything from physical enclosures and power infrastructure to cooling, compute hardware, and monitoring systems. Skipping any one of them creates a gap that shows up later as downtime, emergency purchases, or a retrofit project you didn’t plan for.
Your next move is to assess where you are against each category. If you already have hardware selected, the bigger question is whether your installation plan matches the scope and complexity of what you’re deploying. Poorly executed installs routinely undermine well-specified equipment lists, and that’s where an experienced partner makes the difference.
