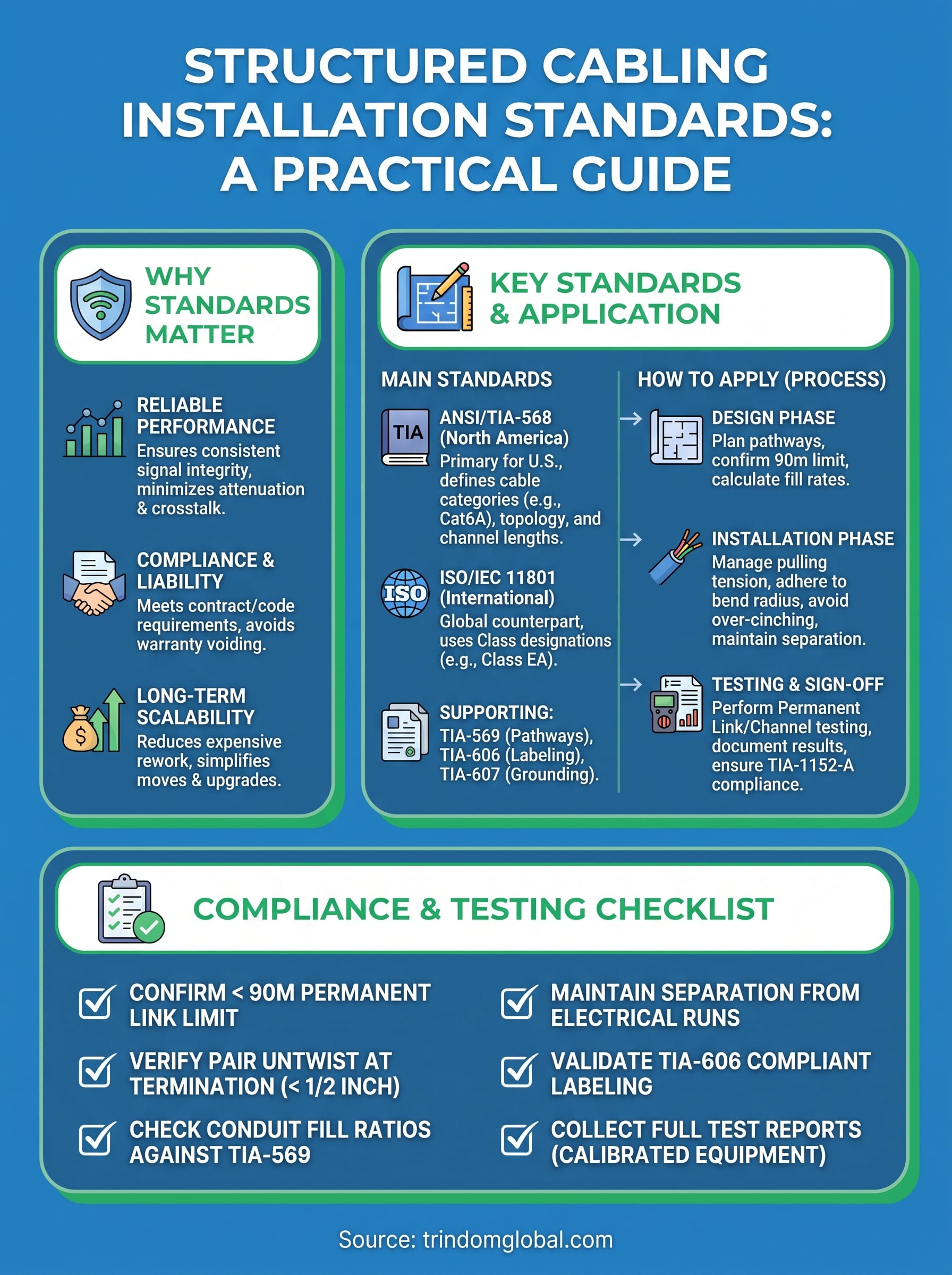

Every cable pull, termination, and pathway decision you make during a cabling project either meets a documented benchmark or it doesn’t. Structured cabling installation standards exist to draw that line. They define how cabling systems should be designed, routed, installed, and tested so that networks perform reliably and scale without expensive rework. Ignore them, and you’re gambling with signal integrity, code compliance, and long-term infrastructure costs.
The major frameworks, ANSI/TIA-568, ISO/IEC 11801, and their supporting documents, cover everything from cable categories and bend radius limits to testing parameters and labeling conventions. Whether you’re wiring a hospital wing, outfitting a commercial building, or running backbone cabling through a multi-family residential campus, these standards apply. They aren’t suggestions. Procurement specs, building codes, and vendor warranties frequently reference them directly, which means non-compliance can stall a project or void coverage when something goes wrong. For government contracts and healthcare facilities, adherence is often a hard requirement before a system even gets powered on.
At Trindom Global, we design, install, and integrate structured cabling systems across healthcare, commercial, hospitality, government, and multifamily environments. Our teams work to these standards daily, not as a checkbox exercise, but because proper standards compliance is what separates infrastructure that lasts from infrastructure that limps along. This guide breaks down the key standards you need to know, what they require, how they interact, and how to apply them in real-world installations. If you’re planning a cabling project, evaluating a contractor’s work, or responding to an RFP, this is the reference point to start from.
Why structured cabling standards matter
A cabling system that looks clean and passes a basic connection test on day one can still fail within a year if the install didn’t follow established benchmarks. Structured cabling installation standards exist because performance isn’t just about whether a signal gets through, it’s about whether it gets through consistently, at rated speeds, across the full system lifecycle. Without a shared framework, every installer makes different decisions about bend radius, termination technique, and pathway routing, and those differences compound into real problems for your network.
Performance and reliability
Signal attenuation, crosstalk, and return loss are measurable physical phenomena that get worse when cables are bent past their minimum radius, over-cinched with ties, or terminated with inconsistent technique. Standards like ANSI/TIA-568 set precise limits for each parameter because engineers tested them and documented exactly what causes failure in the field. When your installer follows those limits, your system performs predictably under load, even at peak traffic.
Category ratings only deliver their rated performance when the entire channel meets the spec. A Cat6A cable terminated on a Cat6 jack drops to Cat6 performance, regardless of how good the cable itself is.
Every component in the channel, from patch panels to connectors to cable runs, must meet the standard or the rated performance is lost. That’s why compliance isn’t optional if you need the throughput you’re paying for.
Compliance, contracts, and liability
Government RFPs, healthcare facility requirements, and commercial build-outs frequently cite TIA or ISO standards as a mandatory acceptance condition. If your cabling system doesn’t pass a third-party compliance test against those parameters, the project doesn’t get signed off, and you absorb the full remediation cost. That’s real financial exposure, not a theoretical risk.
Vendor warranties on active networking equipment often require that the passive cabling infrastructure meet a specific standard. If a switch fails and the manufacturer finds the cabling wasn’t compliant, your warranty claim can be denied outright. Standards adherence protects your investment in both the cabling plant and the equipment running on top of it.
Long-term cost and scalability
Moves, adds, and changes happen in every facility. Staff relocate, new equipment arrives, and technology upgrades require more ports. A cabling system installed to standard comes with accurate documentation, labeled runs, and tested pathways, which means your team can execute changes quickly without tracing unlabeled cables or re-testing entire segments at extra cost.
Future bandwidth upgrades are far simpler when the base infrastructure was installed correctly from the start. Upgrading from 1G to 10G on a properly installed Cat6A plant typically requires only new switches. Doing the same on a non-compliant plant frequently means pulling new cable entirely and absorbing the full labor cost again.
The main standards that govern installation
Two primary frameworks define structured cabling installation standards globally: ANSI/TIA-568 in North America and ISO/IEC 11801 internationally. Understanding which applies to your project, and what each requires, gives you a clear baseline for design decisions, component selection, and third-party testing.
ANSI/TIA-568
The Telecommunications Industry Association (TIA) publishes the ANSI/TIA-568 series, which is the primary reference for structured cabling installations across the United States. The current revision, TIA-568.2-D for balanced twisted-pair and TIA-568.3-D for optical fiber, defines cable categories, channel performance parameters, connector specifications, and maximum channel lengths. Category 6A is now the recommended minimum for new horizontal cabling deployments, supporting 10GBASE-T at distances up to 100 meters.
TIA-568 covers more than cable specs. It also defines topology requirements, including the maximum distance between the telecommunications room and the work area outlet, which directly affects how you plan your floor distribution.
ISO/IEC 11801
ISO/IEC 11801 is the international counterpart to TIA-568, published jointly by the International Electrotechnical Commission and the International Organization for Standardization. Where TIA uses category designations, ISO/IEC 11801 uses class designations (Class EA, Class FA, etc.) that align closely but are not always identical to their TIA equivalents. Projects with international scope, multinational clients, or cross-border procurement often specify ISO/IEC 11801 compliance alongside or instead of TIA.
Supporting standards you need to know
Several additional standards govern specific aspects of a compliant installation. ANSI/TIA-569 covers pathways and spaces, defining how conduit, cable trays, and equipment rooms must be configured. ANSI/TIA-606 establishes the labeling and administration requirements that make your documentation usable over the system’s lifetime. For grounding and bonding, ANSI/TIA-607 applies directly. Each of these works alongside TIA-568 rather than replacing it, and a fully compliant installation addresses all of them together.
How to apply the standards on a real install
Knowing which standards apply is one thing. Actually executing an installation that meets them requires deliberate decisions at every stage, from the design drawing through to the final termination. Structured cabling installation standards don’t only describe outcomes; they prescribe process, and that process starts long before the first cable is pulled.
Start with the design phase
Floor plan analysis and pathway planning are where compliance is either built in or lost. Before anyone pulls cable, you need to confirm that every work area outlet falls within 90 meters of its serving telecommunications room, leaving 10 meters for patch cords and equipment cords on each end to complete the full 100-meter channel. Conduit fill rates, cable tray capacity, and separation distances from electrical sources all require documentation at the design stage, not as an afterthought once the pathways are already installed.

Designing to TIA-569 pathway requirements before construction begins is far less expensive than retrofitting conduit or trays after walls are closed.
Maintain technique during the pull
Pulling tension and bend radius limits must be actively managed on the job site. Cat6A cable has a minimum bend radius of four times its outside diameter, and exceeding it during a pull permanently degrades the internal geometry of the twisted pairs. Your crew should also avoid over-cinching cable ties, which compress the cable jacket and distort the pairs beneath in the same way a sharp bend does.
Separation from high-voltage electrical runs is a field discipline issue, not just a design issue. Installers need to maintain minimum separation distances required by TIA-569 throughout the entire run, not only in the sections that are easy to reach or visible for inspection.
Testing, documentation, and sign-off
An installation that follows structured cabling installation standards during the pull still needs to prove compliance through certified field testing before any sign-off happens. Testing isn’t a formality you run at the end to confirm what you already believe is true. It’s the step that catches problems you can’t see, like a split pair, a damaged connector, or a segment that’s marginally over the 100-meter channel limit.
Field testing requirements
Permanent link and channel testing are the two measurement configurations you need to understand. A permanent link test measures only the fixed cabling from the patch panel port to the work area outlet, excluding patch cords. A channel test measures the full end-to-end path including patch cords. Most owner acceptance testing uses the channel configuration because it represents actual network conditions. Your test equipment needs to be calibrated to the appropriate category level, and you should use a tester that meets the accuracy requirements defined in TIA-1152-A for field test instruments.

A marginal pass on a channel test often points to a termination or connector issue, not the cable itself. Re-terminating a single connector frequently moves a failing link into a clean pass.
Documentation and labeling
Every tested link needs a labeled record that ties the physical cable identifier to the test results file. TIA-606 defines the labeling conventions, and following them means anyone who works on your system five years from now can immediately locate any run, trace its path, and pull up its original test data. Your test report package should include the testing equipment model, calibration date, operator name, test configuration used, and pass/fail result for every parameter on every link. Without that package, you have no defensible sign-off record, and no baseline for future troubleshooting.
Common compliance mistakes and a quick checklist
Even experienced crews make repeatable errors that put projects outside structured cabling installation standards compliance. Most of these mistakes don’t come from ignorance of the rules. They come from time pressure, inadequate supervision, or skipped verification steps that seem minor until a test report returns with failures across multiple links.
Mistakes that show up repeatedly
Over-untwisting pairs at termination points is the single most common cause of near-end crosstalk failures on Cat6 and Cat6A links. Each pair must be untwisted no more than half an inch at the termination point. Beyond that limit, the electrical separation between pairs collapses and crosstalk rises sharply, often enough to fail the full channel test.
Untwisting more than half an inch at termination is the most preventable cause of crosstalk failures, and also the easiest to correct before the connector is punched down.
Pulling cable without checking conduit fill ratios is another frequent error. Overfilled conduit forces cables into tight bends at entry and exit points, and those bends often exceed the minimum bend radius for the cable type. Exceeding that radius permanently degrades the twisted-pair geometry, and no amount of re-termination corrects the damage after the fact.
Quick compliance checklist
Run through this list before you close any walls or submit a final test report. It targets the most common failure points across real installations:
- Confirm every horizontal run stays at or under the 90-meter permanent link limit
- Verify pair untwist at all terminations stays at or under half an inch
- Check conduit fill ratios against TIA-569 limits at every entry and exit point
- Confirm cable tray separation from high-voltage electrical runs meets minimum clearance requirements
- Validate that all ports carry TIA-606 compliant labels before testing begins
- Collect test reports with calibration dates and operator names before requesting sign-off

What to do next
Structured cabling installation standards give you a concrete framework to evaluate every decision on a cabling project, from the design drawing through to the final test report. Apply the standards correctly, and you get infrastructure that performs at rated speeds, documents cleanly, and scales without costly rework. Skip steps or treat compliance as optional, and you inherit failures that are expensive to diagnose and even more expensive to fix after the walls are closed.
If you’re planning a new installation, responding to an RFP, or evaluating an existing plant that may not meet current benchmarks, the right starting point is a conversation with a team that works to these standards on every project. Trindom Global designs and installs structured cabling systems across healthcare, commercial, hospitality, government, and multifamily environments. Reach out to our team and tell us what you’re working on. Get in touch with Trindom Global to start planning your next project.
